Foundation Verification
Foundation is visually checked to verify that nothing has shifted or moved after the forms are set. Foundation is visually verified after the footings are poured, then after the forms are removed and finally after the foundation is backfilled.
The red outline is the original placement of the footing forms.

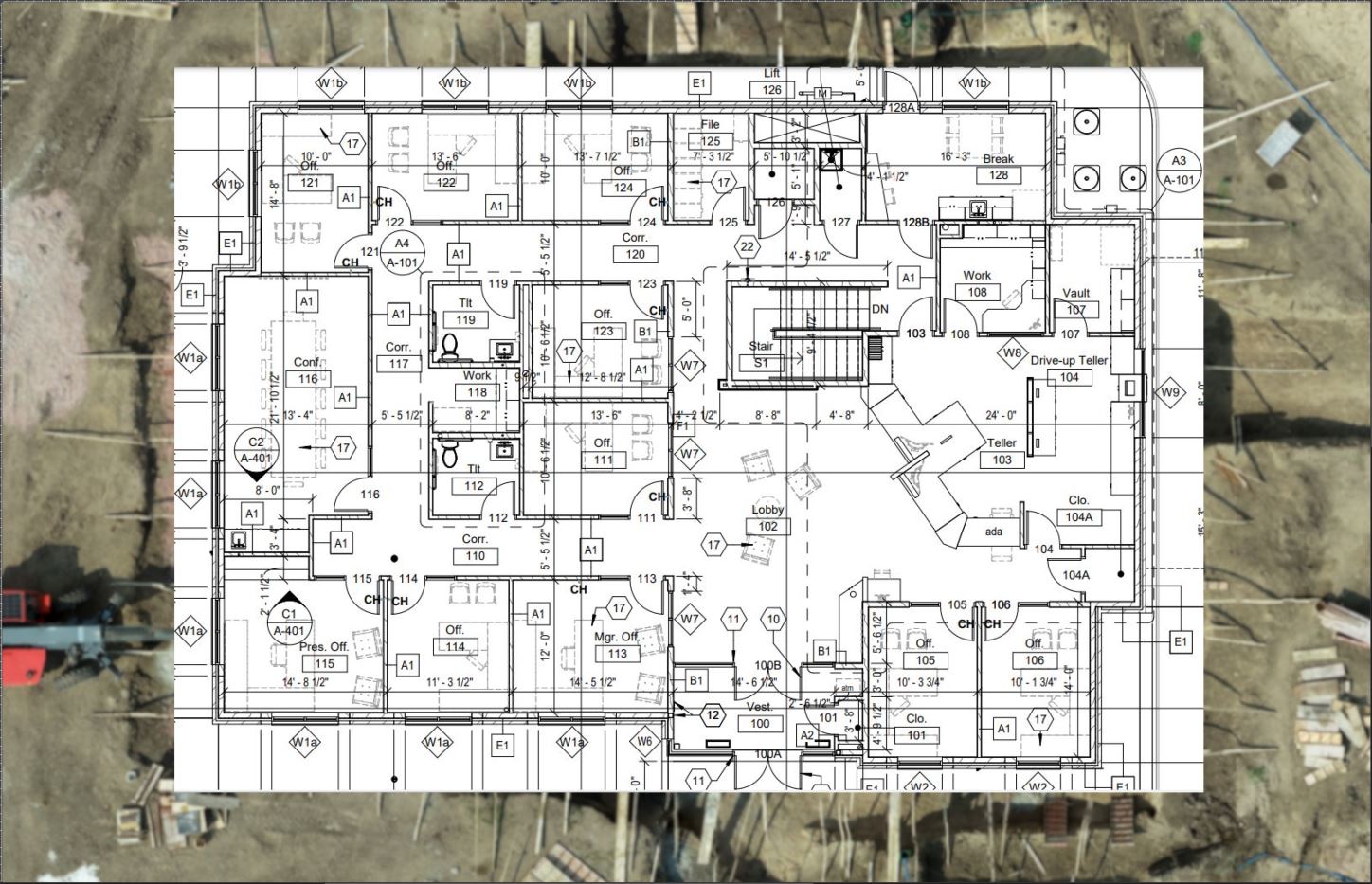

The overlay used to for verification is derived from the actual floorplans.

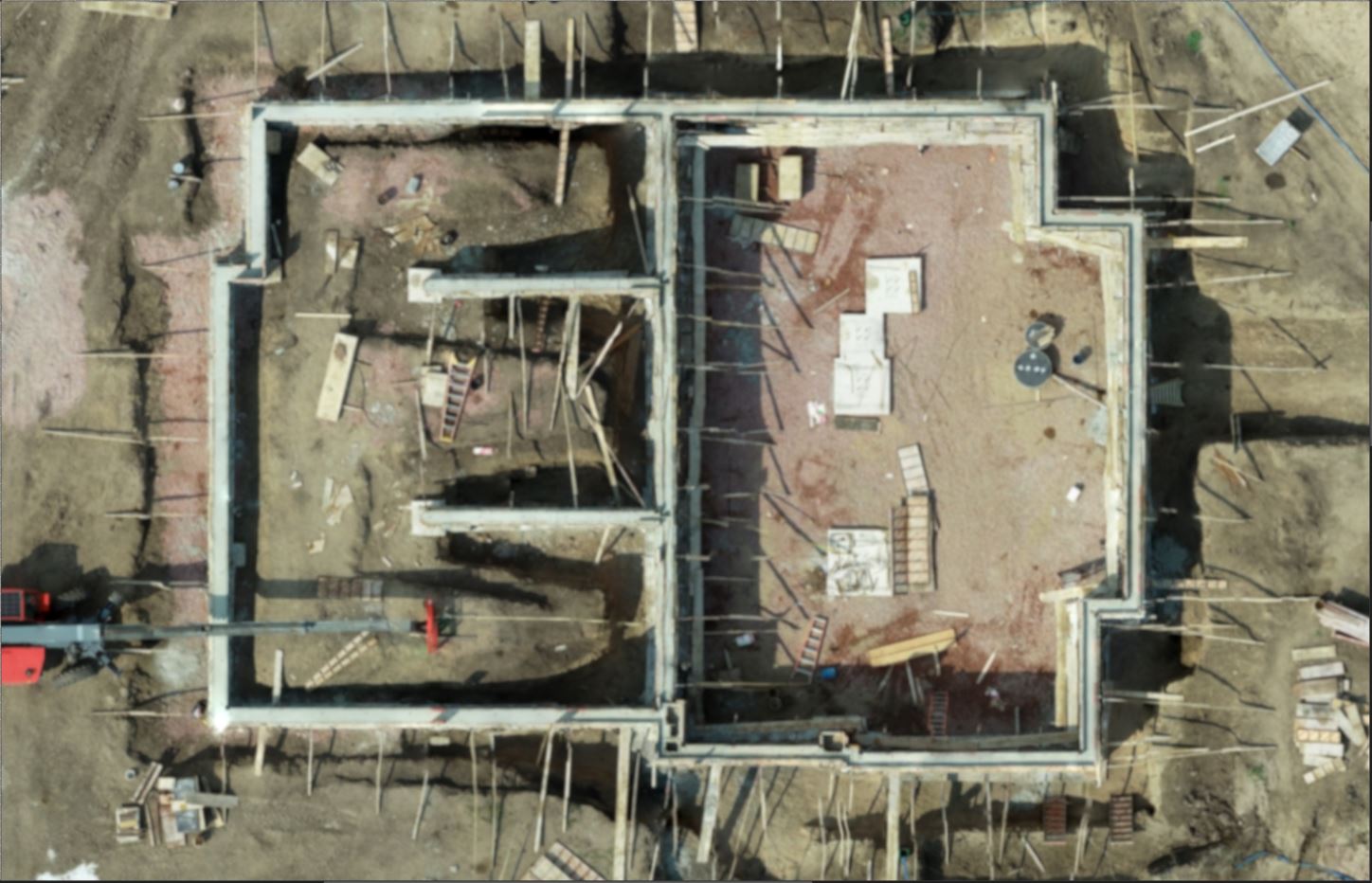

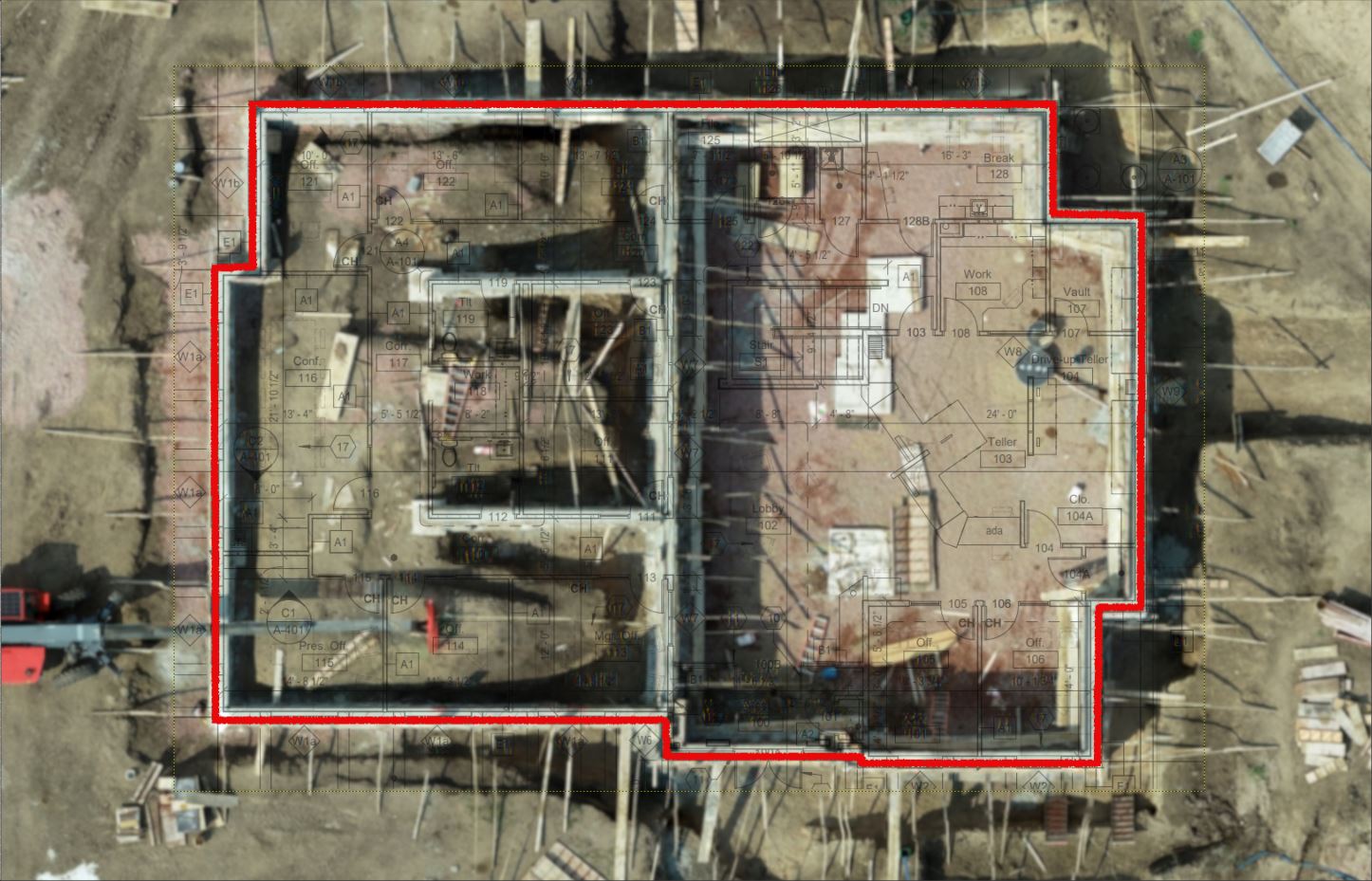

Verified after the foundation is poured as of August 20, 2023.

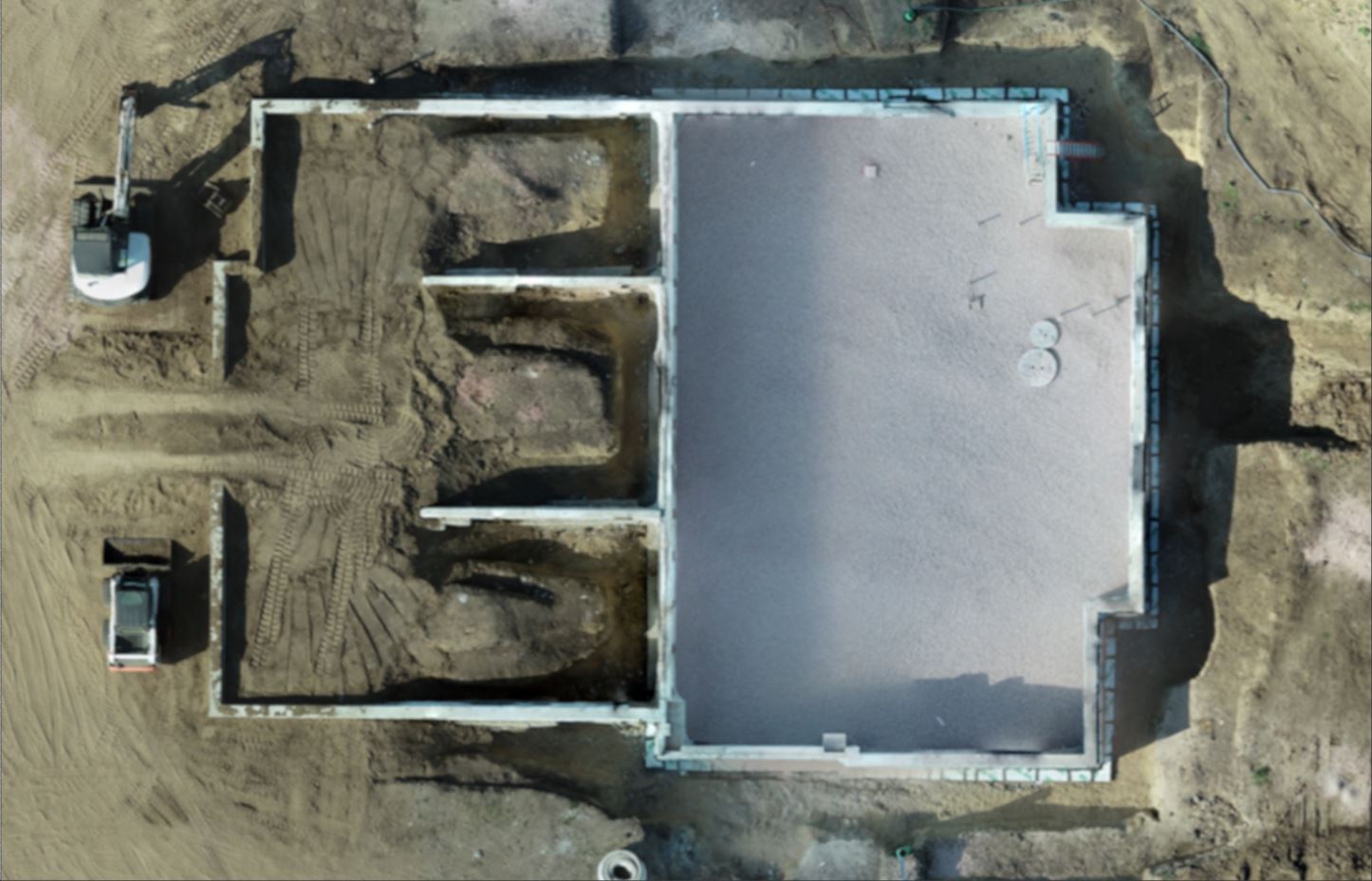

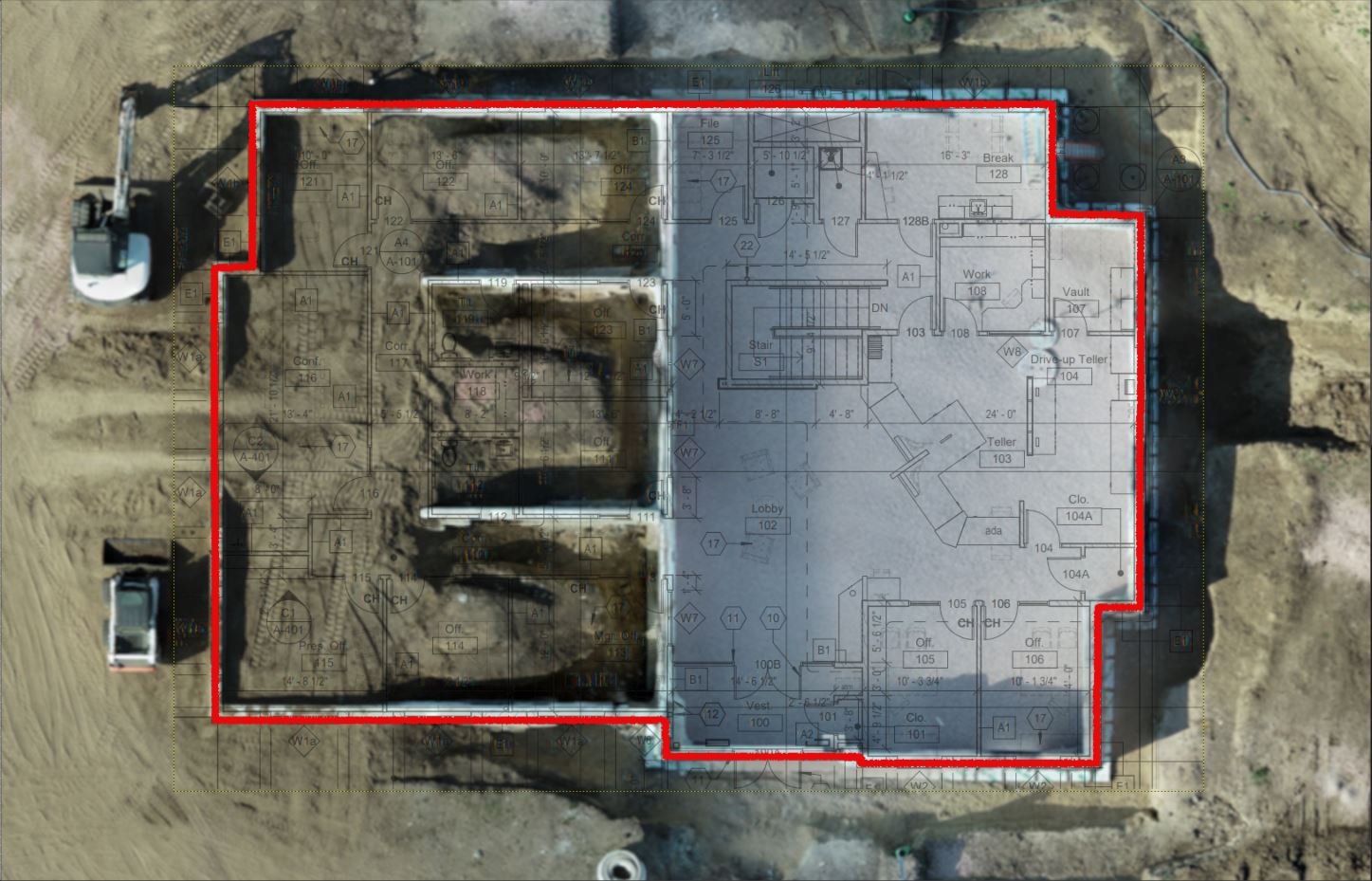

Verified after the forms are removed on August 27, 2023.

Verification after the foundation walls are partially backfilled and before steel re-enforcement beams are installed as of September 8, 2023.

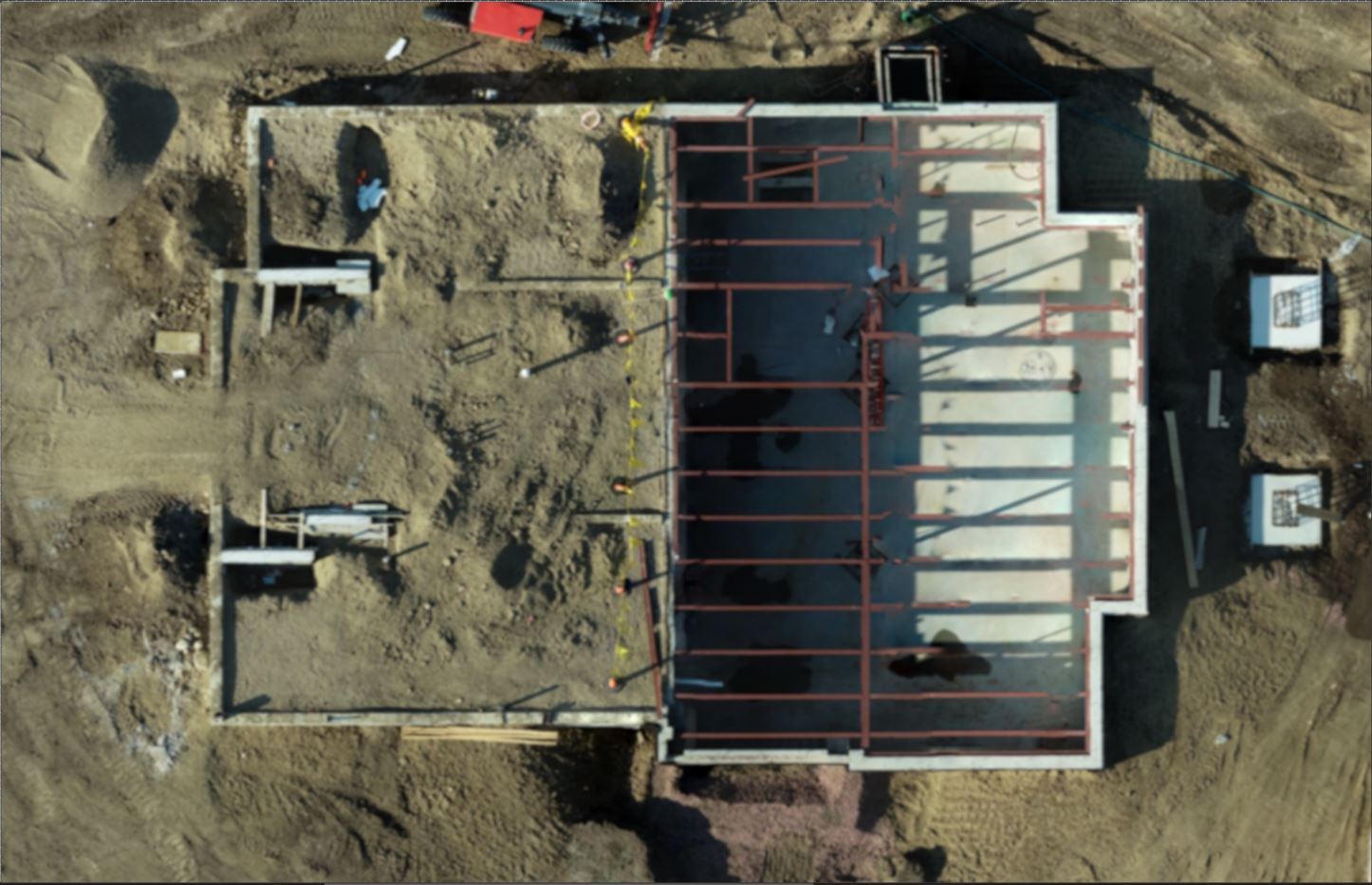

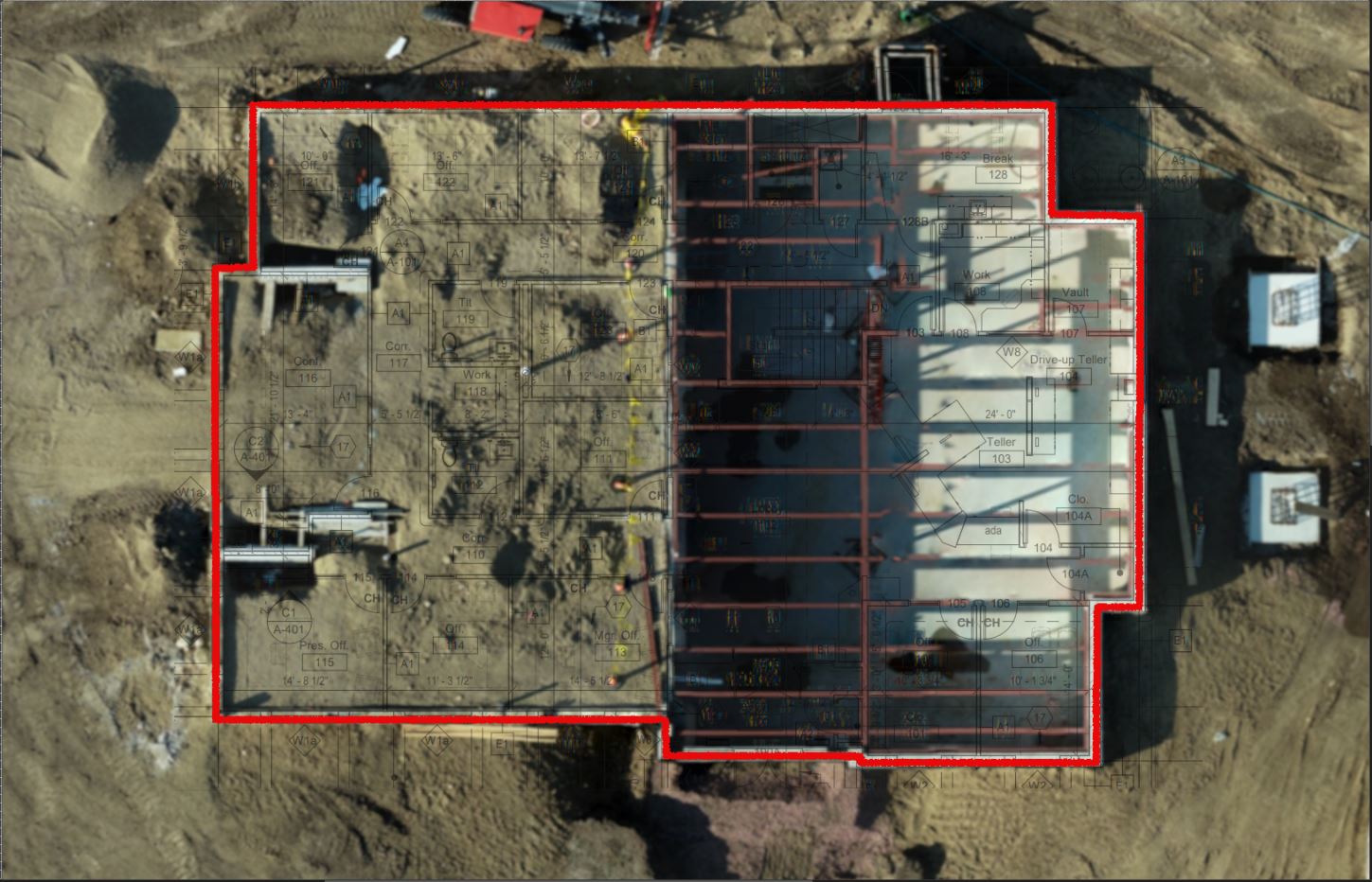

Final verification after the foundation walls are completely backfilled as of September 15, 2023.

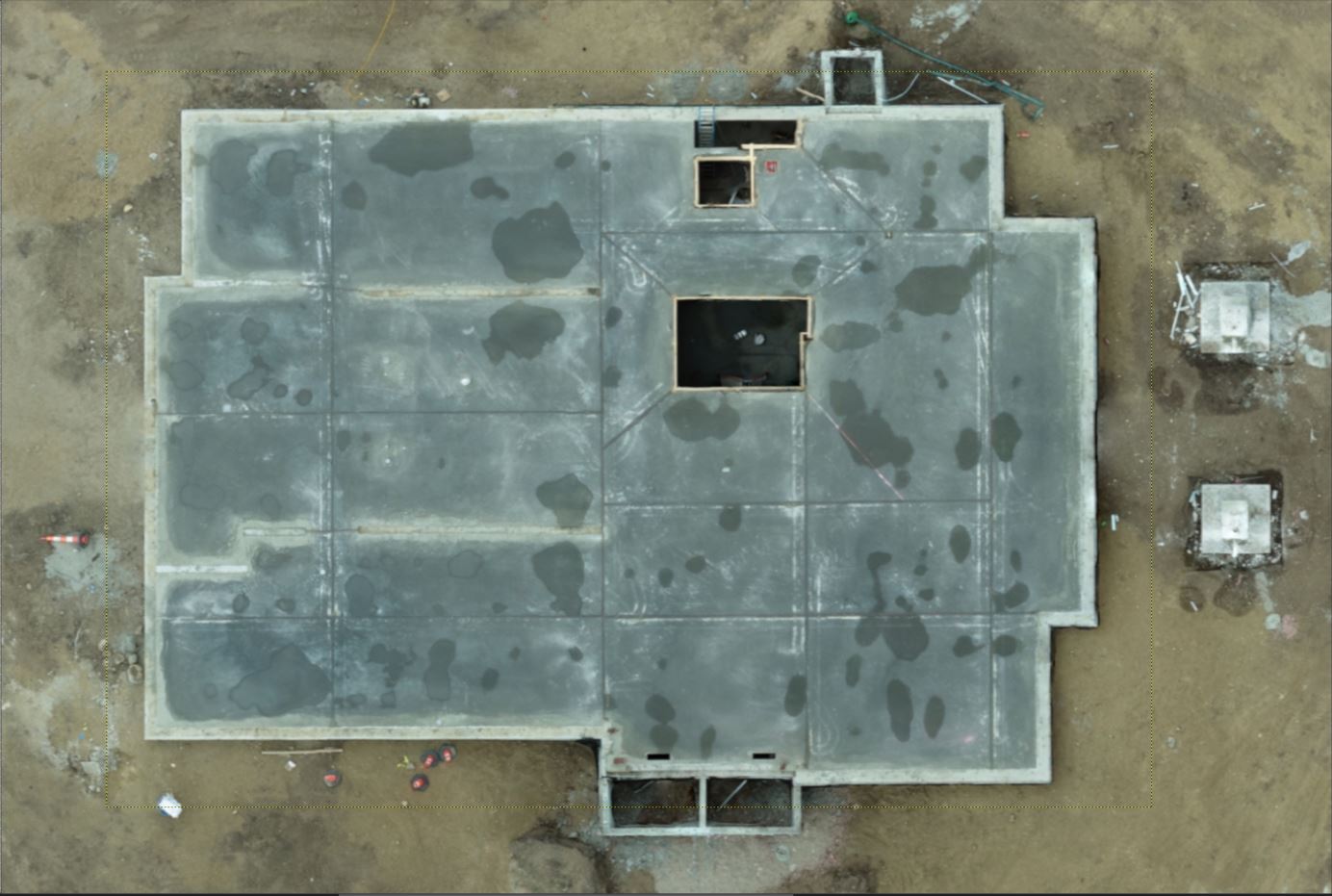

Final verification after the main level slab was poured as of September 23, 2023.
